Choose made-to-order when no stock fixture matches your dimensions, finish or light count. Choose in stock when you need the light this week or might send it back. A made-to-order fixture is built to your spec, so production takes weeks and the sale is usually final, which makes four checks before you pay worth more than any discount.

Should you buy made-to-order or in stock?
Both answers are right, and the deadline chooses for you. In stock exists because a factory guessed the size, finish and light count ahead of demand, so it ships in days and can come back. Made-to-order exists because no guess matches every room: a 17-foot stairwell, a 62-inch dining table, or a wall that takes a 24-inch sconce where 20 inches would crowd the door trim.
Match the choice to your schedule first and the look second, then use the table to see what each path costs you.
| Decision | Made-to-order | In stock (ready to ship) |
|---|---|---|
| Lead time | Weeks: engineering, production, finishing, QC, then freight | Days: it leaves the warehouse |
| Size freedom | Any diameter, drop, light count or finish you approve | Fixed to whatever was made |
| Returns | Usually final sale; defects and damage covered, change of mind often not | Standard return window, original packaging |
| Budget | Higher per unit, plus oversize freight | Lower, and often discounted |
| Best for | Odd dimensions, long runs, statement pieces | Deadlines, samples, low-commitment rooms |
What does the made-to-order timeline actually look like?

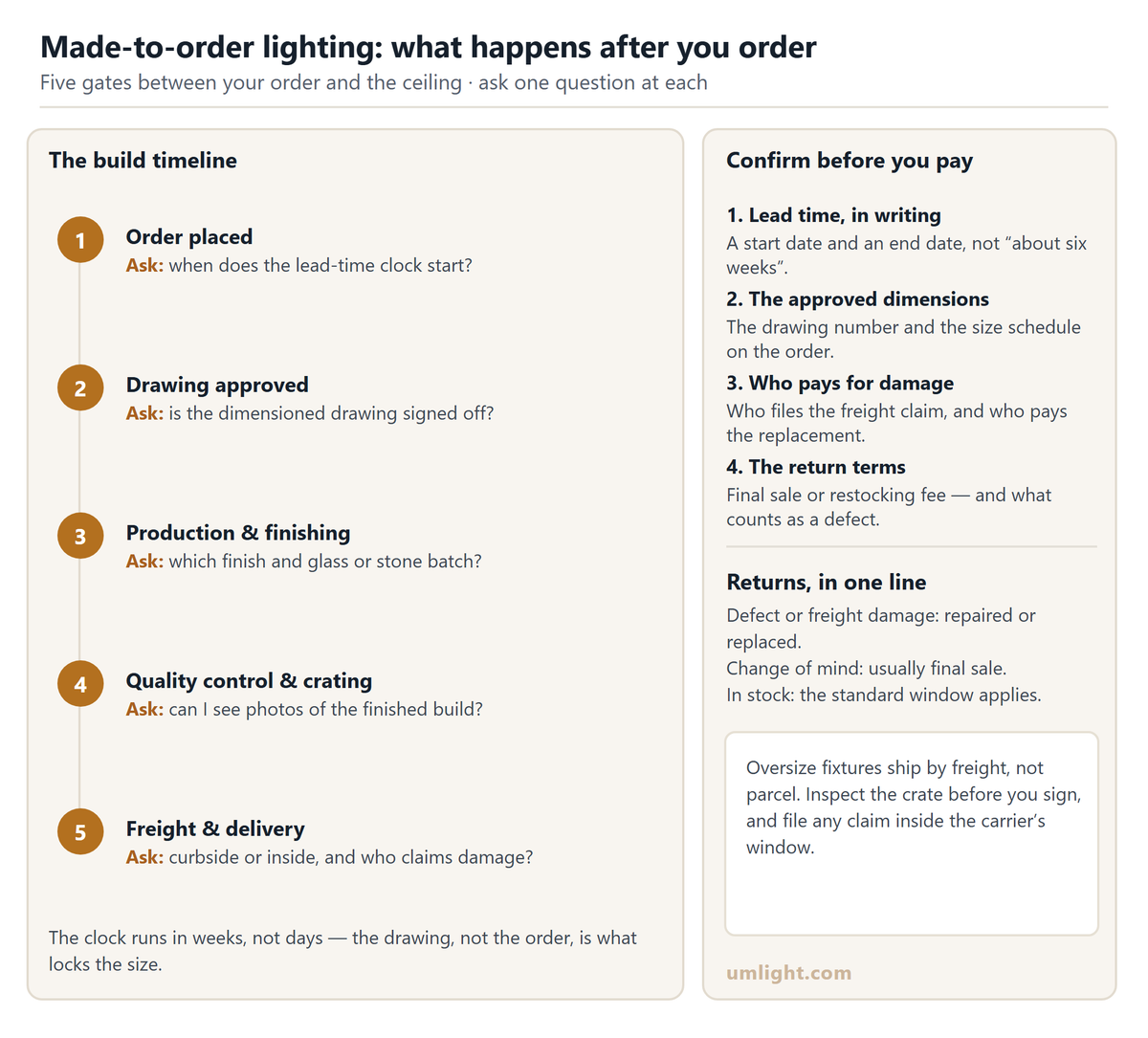

The order is not "paid, then wait". It runs through five gates, and each one is a chance to catch an error while the fixture is still on paper.
- Order placed. Ask when the clock starts: the order date, or the date you approve the drawing. Get both dates in writing before you pay.
- Engineering and shop drawing. Ask for a dimensioned drawing to sign, and check the diameter, drop, canopy and light count line by line. Nothing should be cut before you approve it.
- Production and finishing. Ask which finish and which glass or stone batch your order will use, and what size tolerance is normal. Hand-finished stone and glass vary by a few millimetres, not zero.
- Quality control and crating. Ask for photos of the finished fixture and the packed crate, plus the packed weight and carton dimensions.
- Freight. Ask the carrier, the freight class, and whether delivery is curbside or inside. Oversize fixtures move by freight, not by parcel courier.
- Delivery and acceptance. Inspect the crate before you sign, photograph any crush or break, and file the claim inside the carrier's window, which is often days rather than weeks.
Confirm these four things before you order
- The lead time, start to finish, in writing. Ask for the date the clock starts and the date it gates on. "About six weeks" is not a date.
- The exact dimensions you approved. Ask for the drawing number and the schedule of sizes on the order. A drop quoted in centimetres on the drawing and inches on the listing is where wrong orders begin.
- Who pays if it arrives damaged. Ask who files the freight claim, who pays for the replacement, and whether a second long build restarts the clock.
- The return terms before you pay. Ask whether the piece is final sale, what counts as a defect, and who covers return freight. Get the answer in writing.
How do custom sizes change the price?
A custom size is not a flat surcharge; the price steps with the material and the light count. More glass, more shades and more sockets each add cost in stages, so one family can span two to three times from its smallest build to its largest. The published variant prices show how the steps land, and the live page is the only price that counts on the day you buy.
The Modern Alabaster Multi-Layer Chandelier makes the width step visible: three diameters across a range from about $1,205 to $2,945. Light count moves the number on its own sibling, the Modern Alabaster Global Staircase Chandelier, which climbs from a 3-light build to an 18-light one across roughly $690 to $2,990.
Length and height are the only variables on some pieces. The Modern Lamps Linear Alabaster Chandelier runs from $2,489 in the small build to $3,689 in the large, while the Leafloor Modern Linear Chandelier 62" is one fixed length at a single price. Wall lights step by height instead: the Modern Luminara Alabaster Wall Sconce is about $389 at 19.7 inches and $465 at 23.6 inches, so two inches of body is where most of the jump sits.
How do returns work on made-to-order lighting?
Made-to-order usually sits outside a standard return window, because nobody else can resell the size you chose. Expect a defect or freight damage to be fully covered, and a change of mind to be refused or charged a restocking fee. Ask for the terms in writing before you pay, and keep the crating until you have switched the fixture on.
Three outcomes cover most orders. A defective part is repaired or replaced after you send photos and the batch number. Freight damage is a claim against the carrier, filed fast and photographed before you sign. A change of mind is the only one that is usually final sale, which is why the four checks above matter more than the discount.
For in-stock fixtures the ordinary return window applies, so read it before ordering and keep the original packaging until the piece is installed and working.
FAQ
How long does made-to-order lighting take?
Plan on several weeks once you approve the drawing, then add freight time on top. Six to twelve weeks is a common range for a built-to-spec fixture, and hand-finished glass or stone sits at the longer end. Confirm the exact dates on your order before you pay.
Can I change the size of a made-to-order fixture?
Yes, that is the whole point of ordering made to measure: you approve a dimensioned drawing, and the diameter, drop and light count are built to it. Change the drawing after production starts and the price and lead time restart. Change it before you sign and it is just an edit.
Are made-to-order lights returnable?
Usually only when something is wrong. A defect, a wrong size against the approved drawing, or freight damage is covered and fixed. A change of mind on a built-to-spec piece is typically final sale or carries a restocking fee, so confirm the term in writing first.
What should I confirm before ordering a custom fixture?
Four things: the lead time in writing with a start and an end date, the exact dimensions you approved, who pays if it arrives damaged, and the return terms. A fixture that fails any of the four is a fixture to renegotiate before you pay, not after.
Does a custom size always cost more?
Almost always, and it steps with material rather than jumping once. Bigger glass, more shades and more sockets add cost in stages, so the same family can span two to three times from its smallest to its largest build. Ask for the variant breakdown so you can see which step you are buying.
Do stock and custom fixtures ship the same way?
No. In-stock pieces usually ship by parcel in days and come back easily. Oversize custom pieces move by freight, which is slower, costs more, and needs someone on site to inspect the crate before signing. That last step is where most damage disputes are won or lost.
Sources
- FTC — Mail, Internet, or Telephone Order Merchandise Rule — the 30-day shipping-and-notice rule behind any lead-time promise — ftc.gov.
- NFPA 70 (National Electrical Code) — equipment must be installed and used per its listing and instructions — nfpa.org.
- NFPA — Home electrical safety — the installation and cord rules an electrician works to — nfpa.org.
- UL Solutions — certification and listing — what the UL mark on a fixture actually certifies — ul.com.
- ENERGY STAR — light fixtures — performance and quality marks a light should carry before it ships — energystar.gov.
Lead times, tolerances and freight terms here are common industry practice, not a fixed rule — the dates and terms on your own order and the FTC's shipping rule govern them. Check the fixture's label for its listing and ratings, and have hard-wired work and ceiling-box support installed by a licensed electrician.
